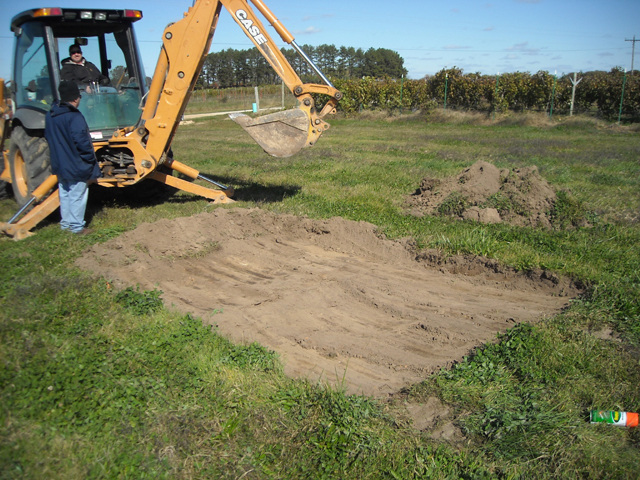

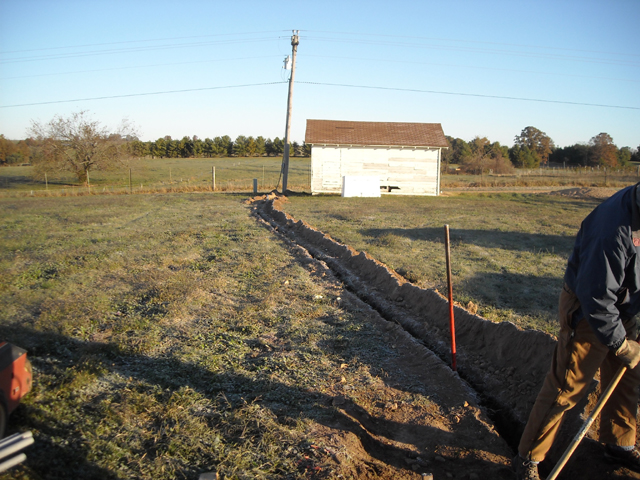

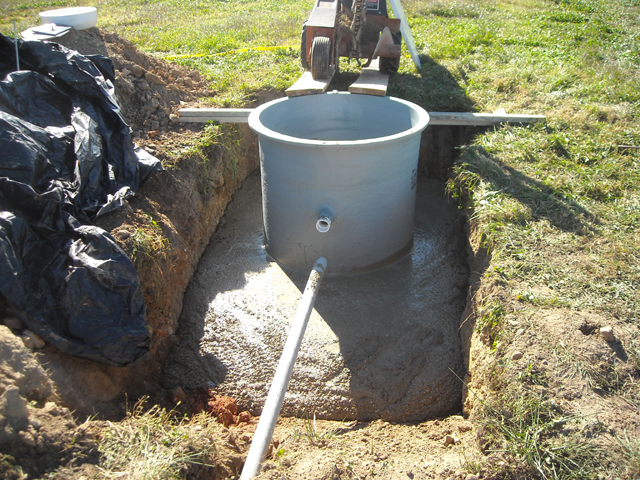

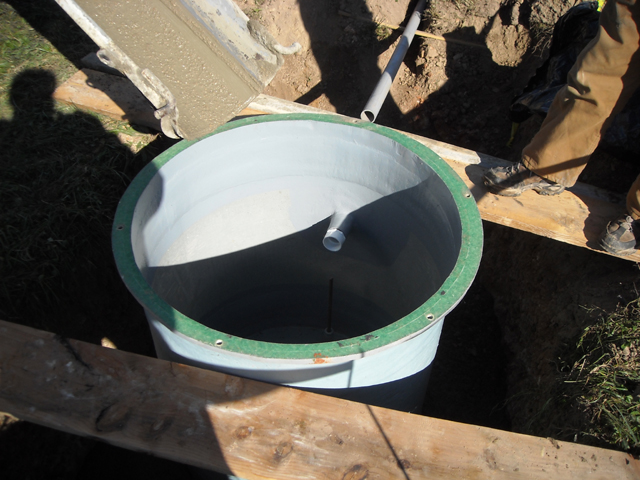

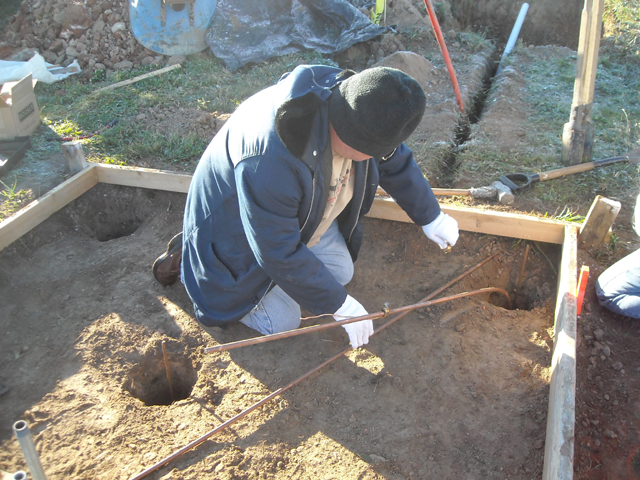

- preparing bed for shelter's concrete pad

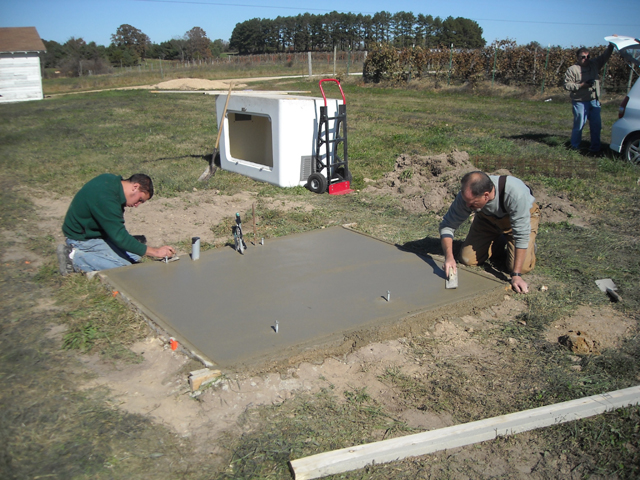

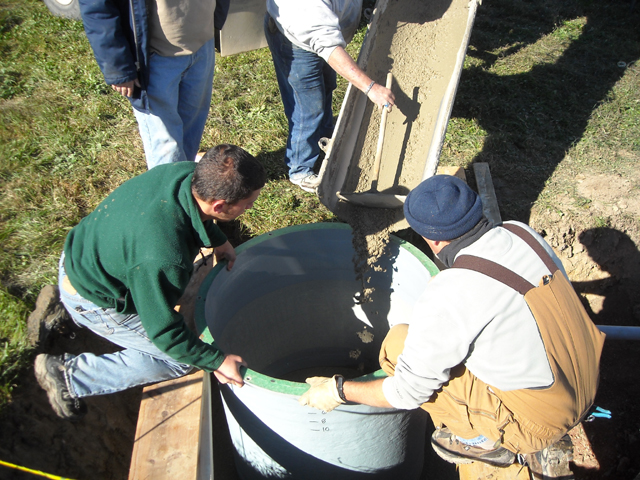

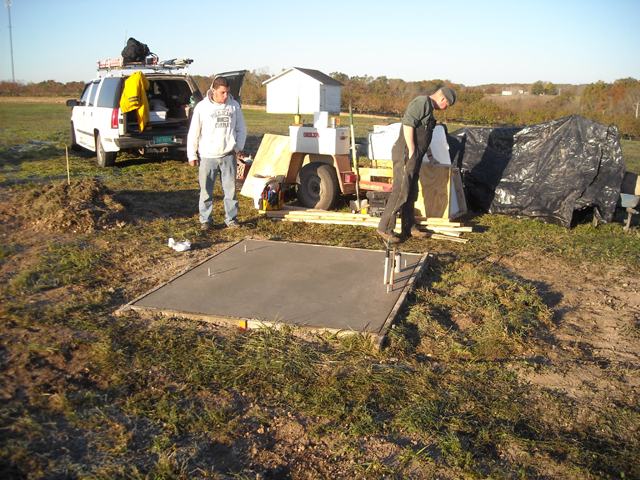

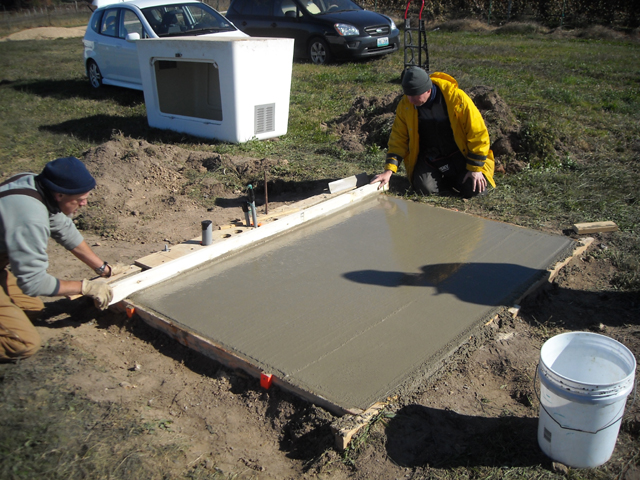

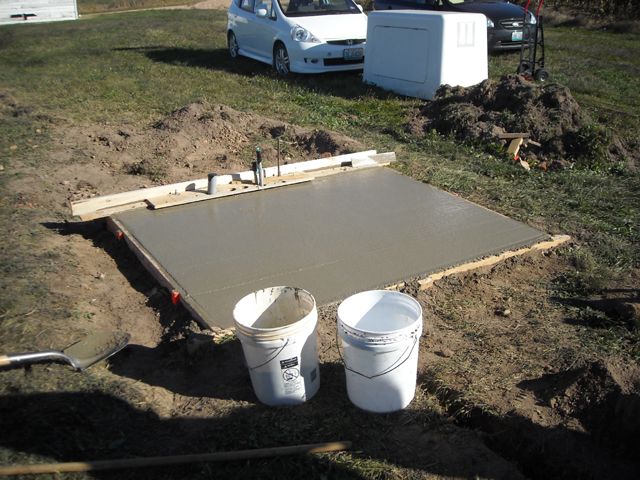

- finishing shelter slab after concrete pour

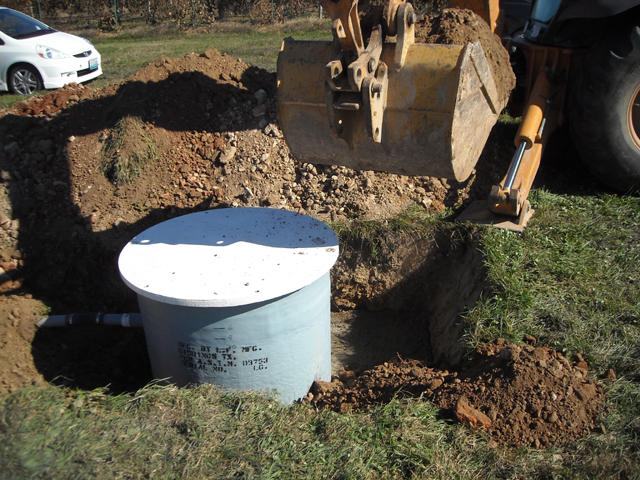

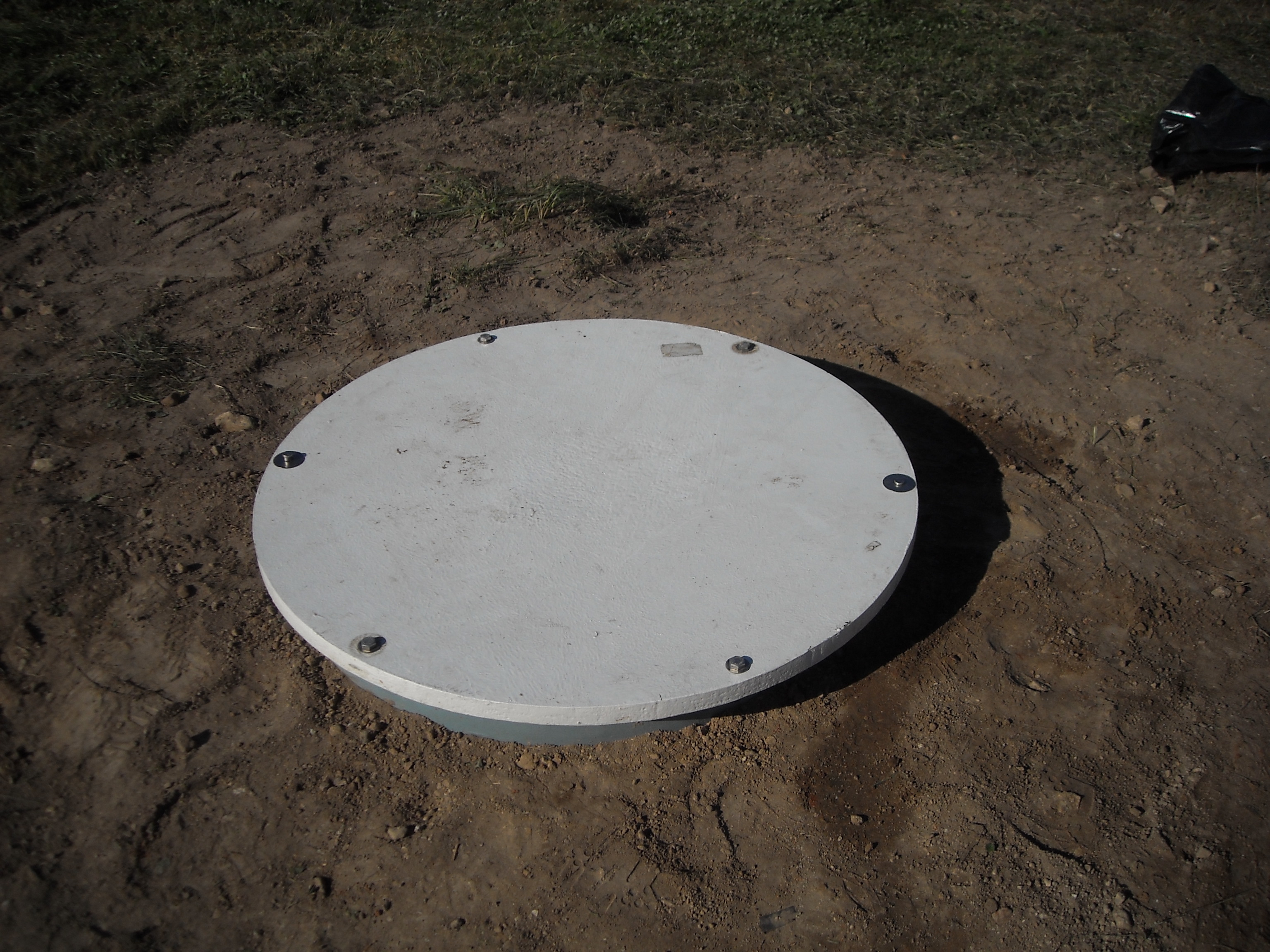

- finished concrete slab

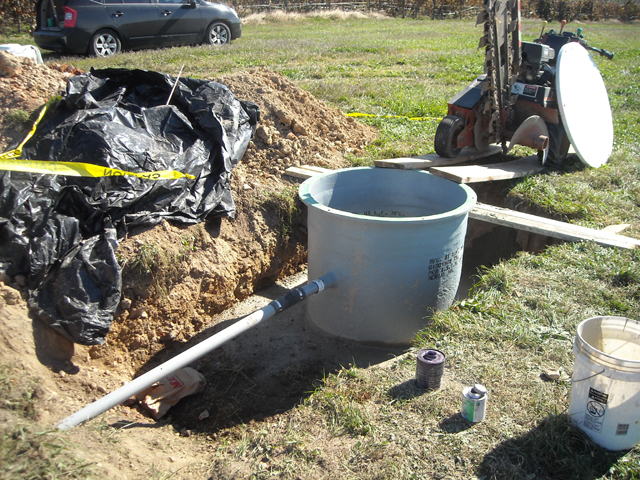

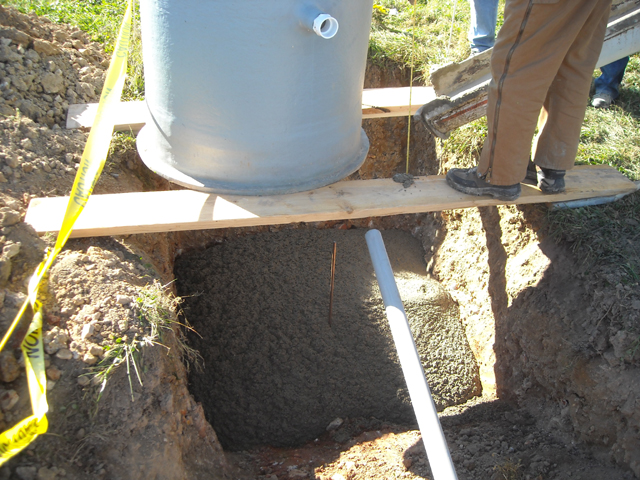

![]() ![]() ![]() vault installed, installing granite plates for trillium and episensor instruments |

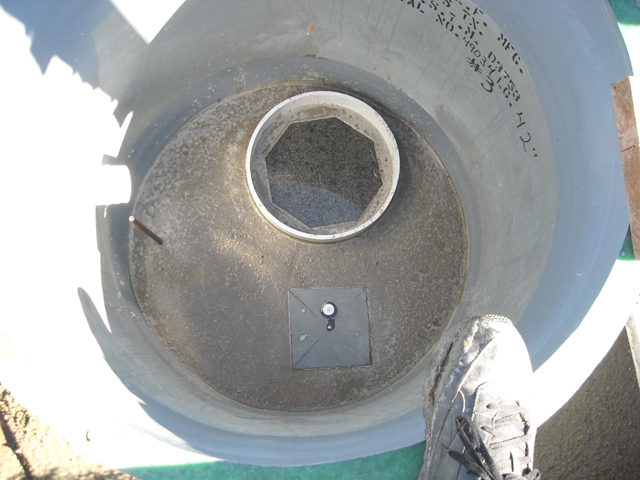

![]() view inside the vault at instruments' granite plate |

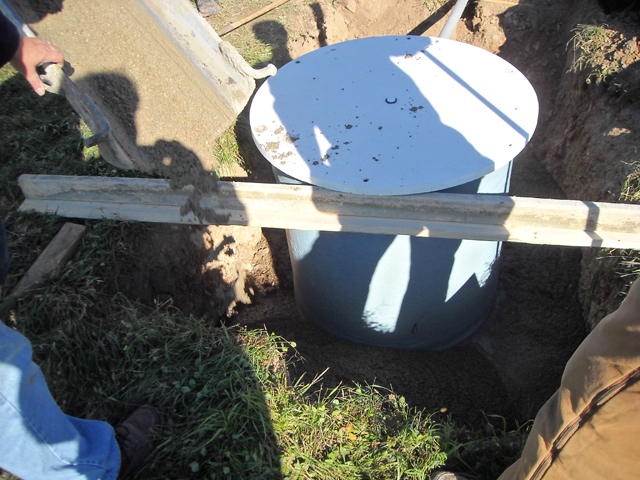

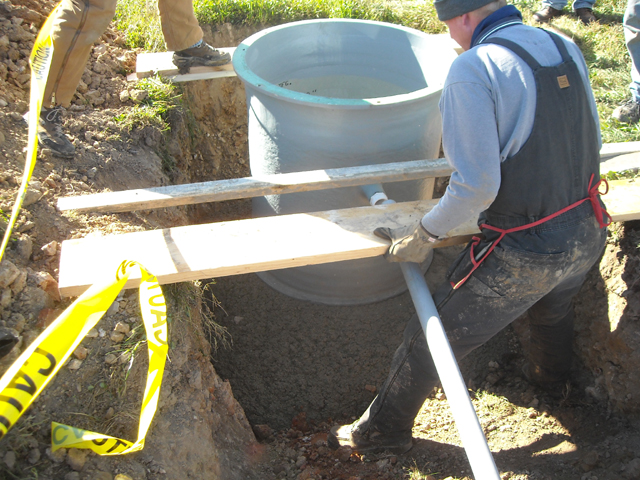

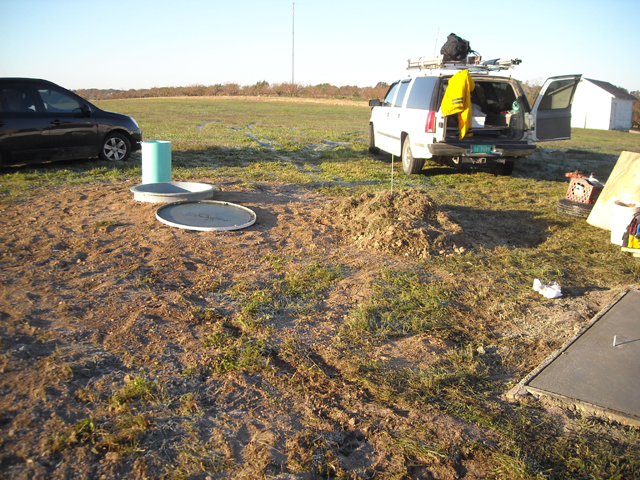

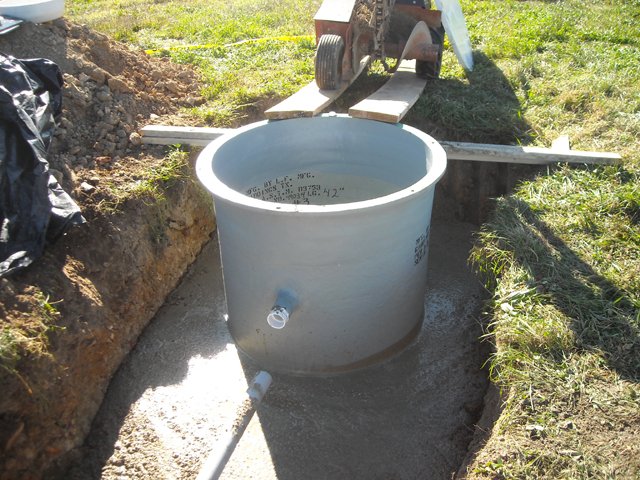

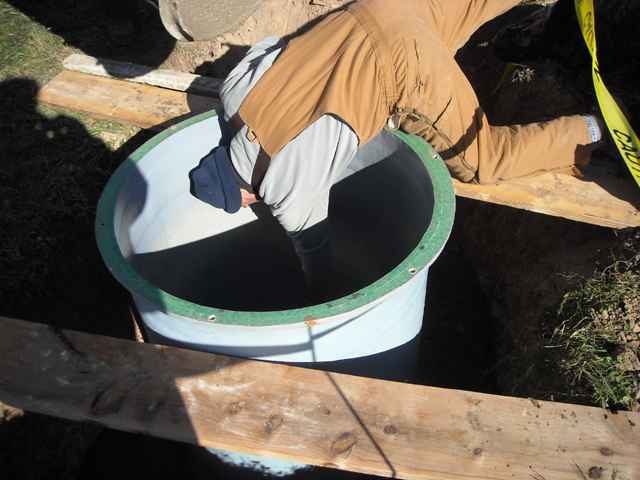

- vault installed, needed a little extra weight to keep it from floating

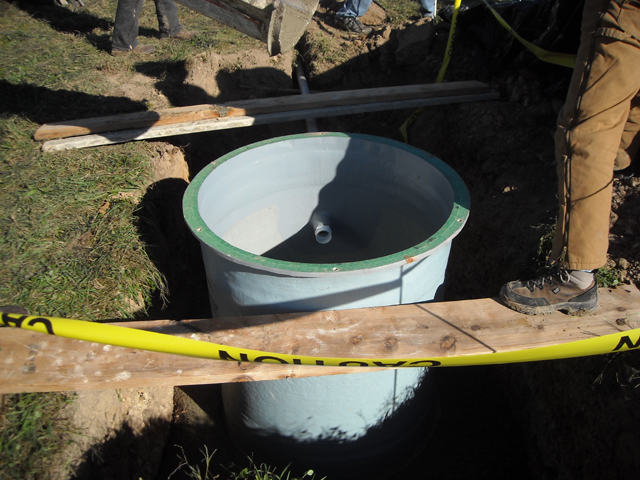

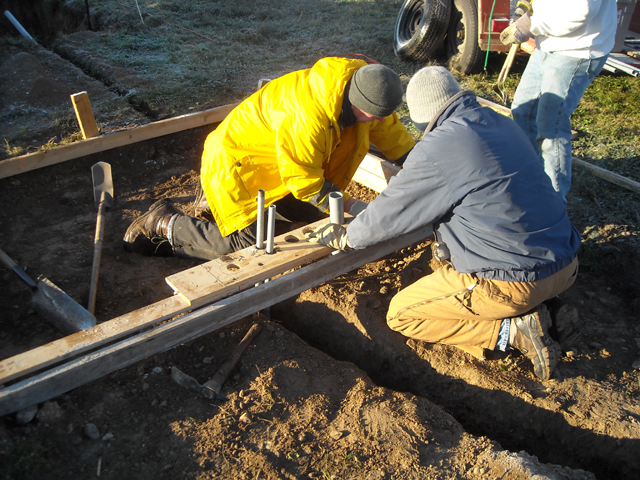

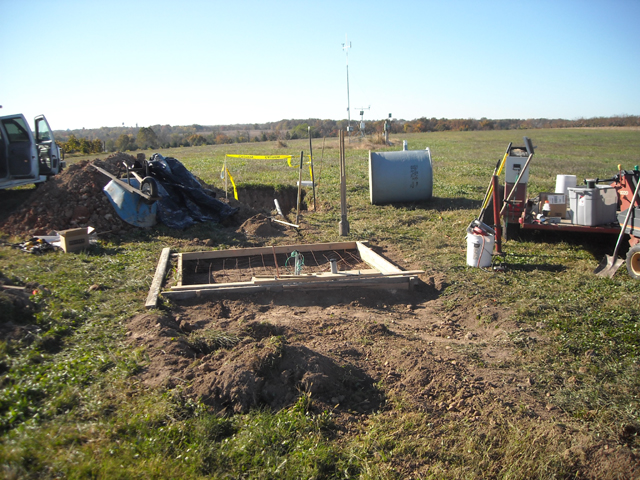

- finish trim work on instrument shelter pad

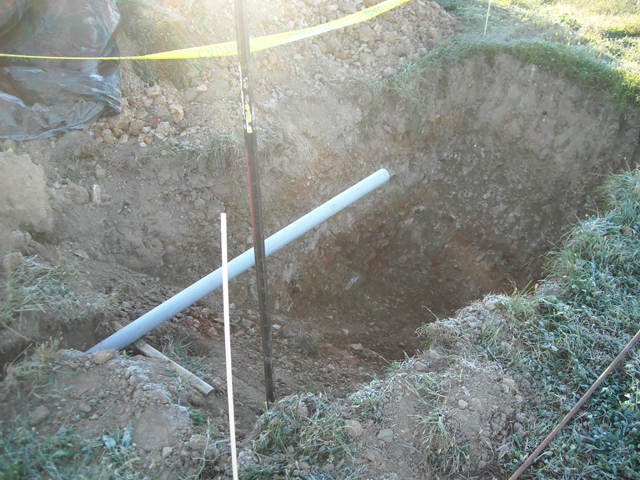

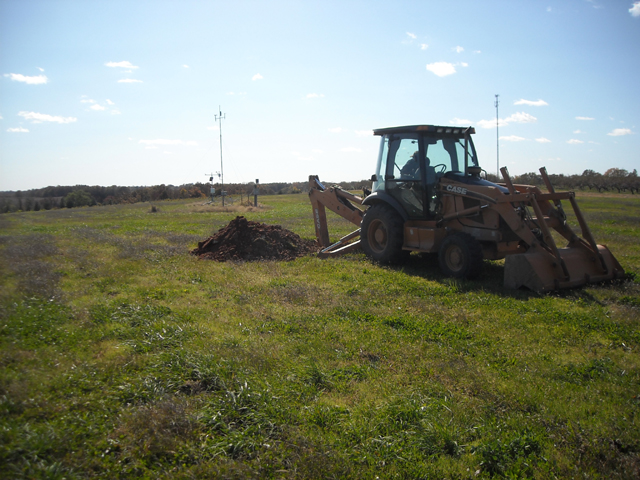

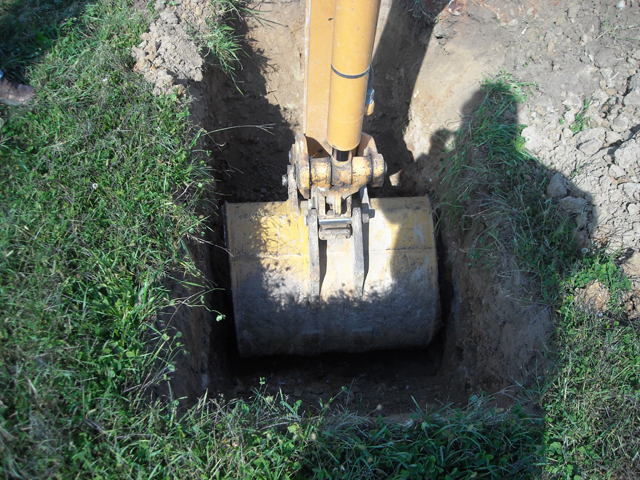

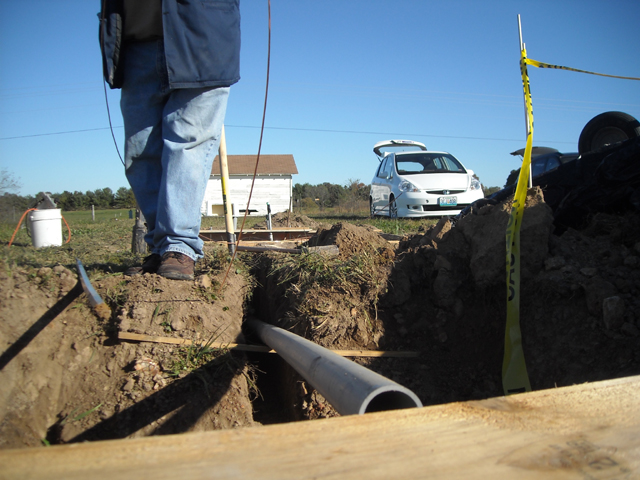

- backfilling instrument hole with dirt

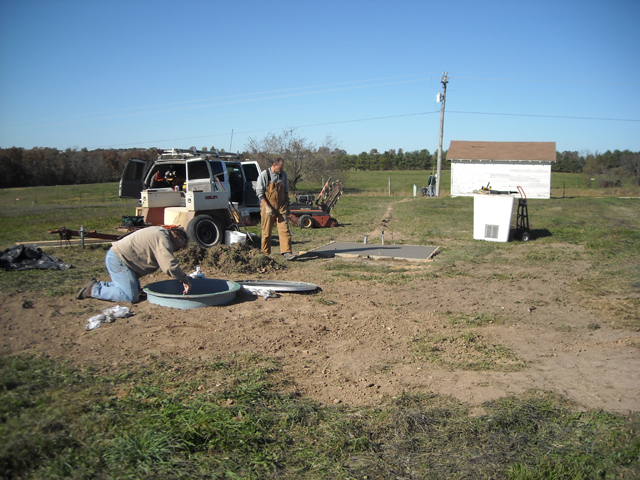

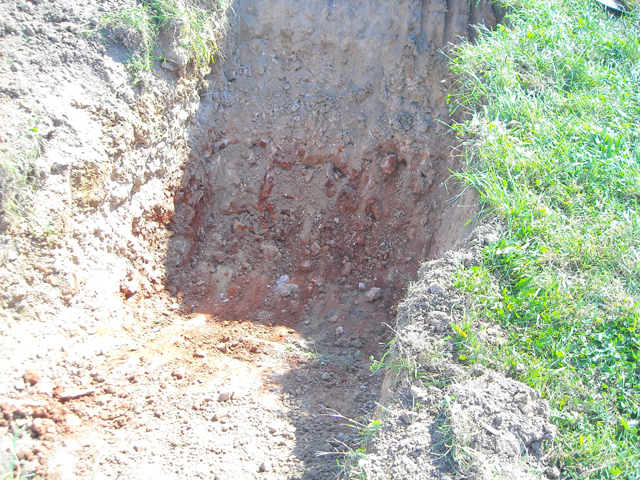

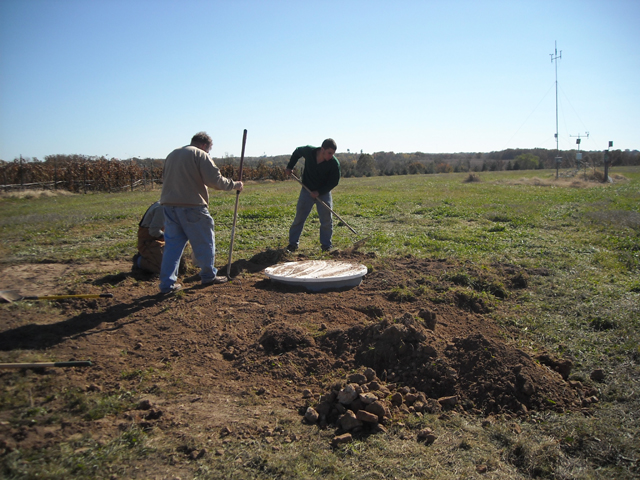

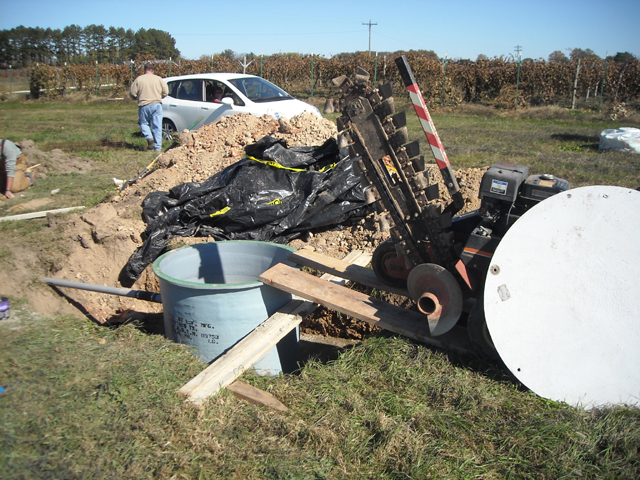

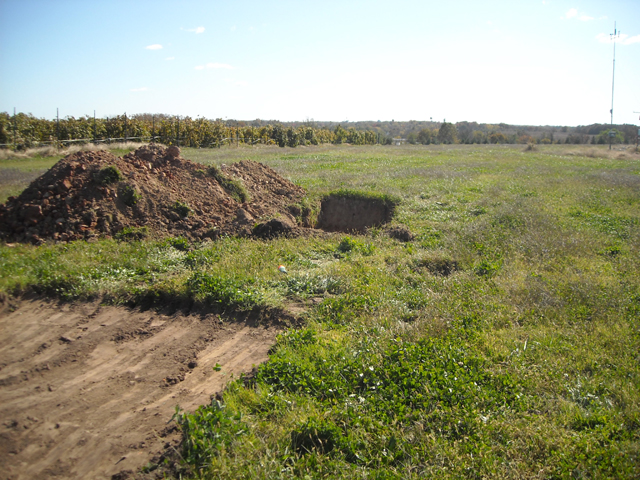

- finishing up the site trying to find the dirt in the rock

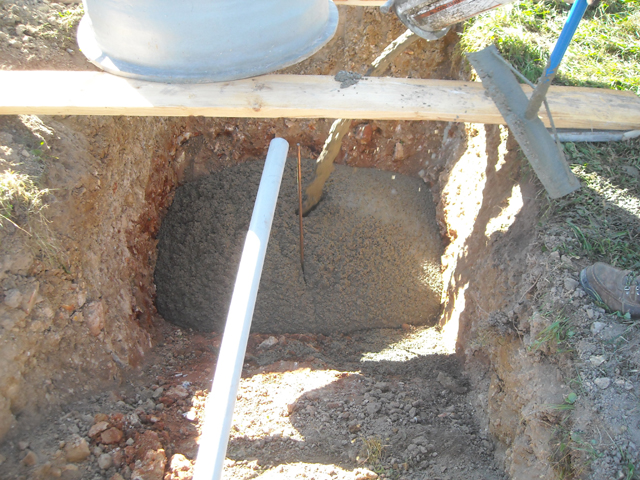

- closing up the site to let the concrete fully cure

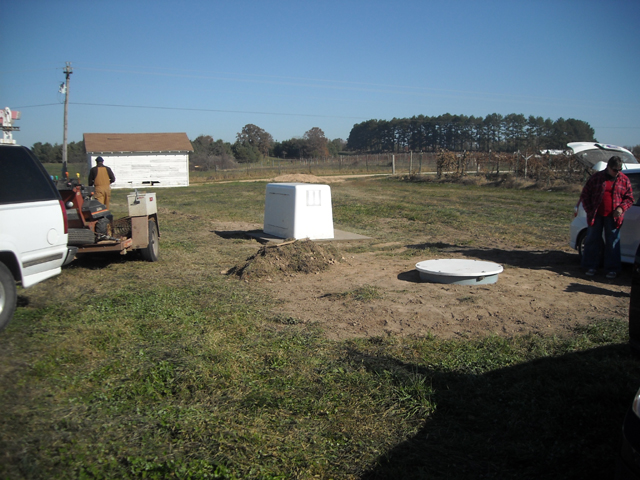

- Pad and site the next morning after concrete cured

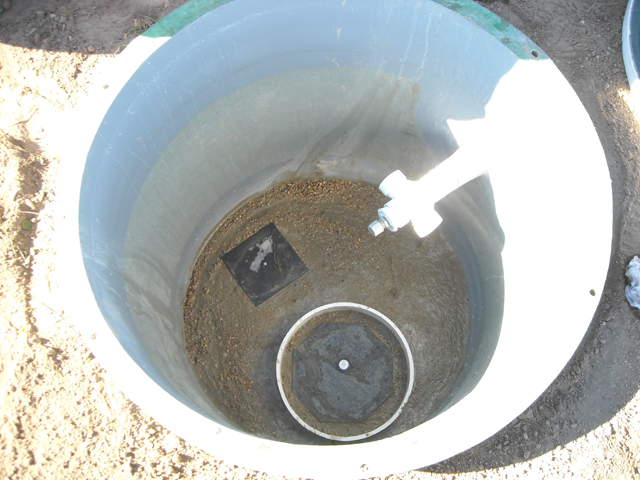

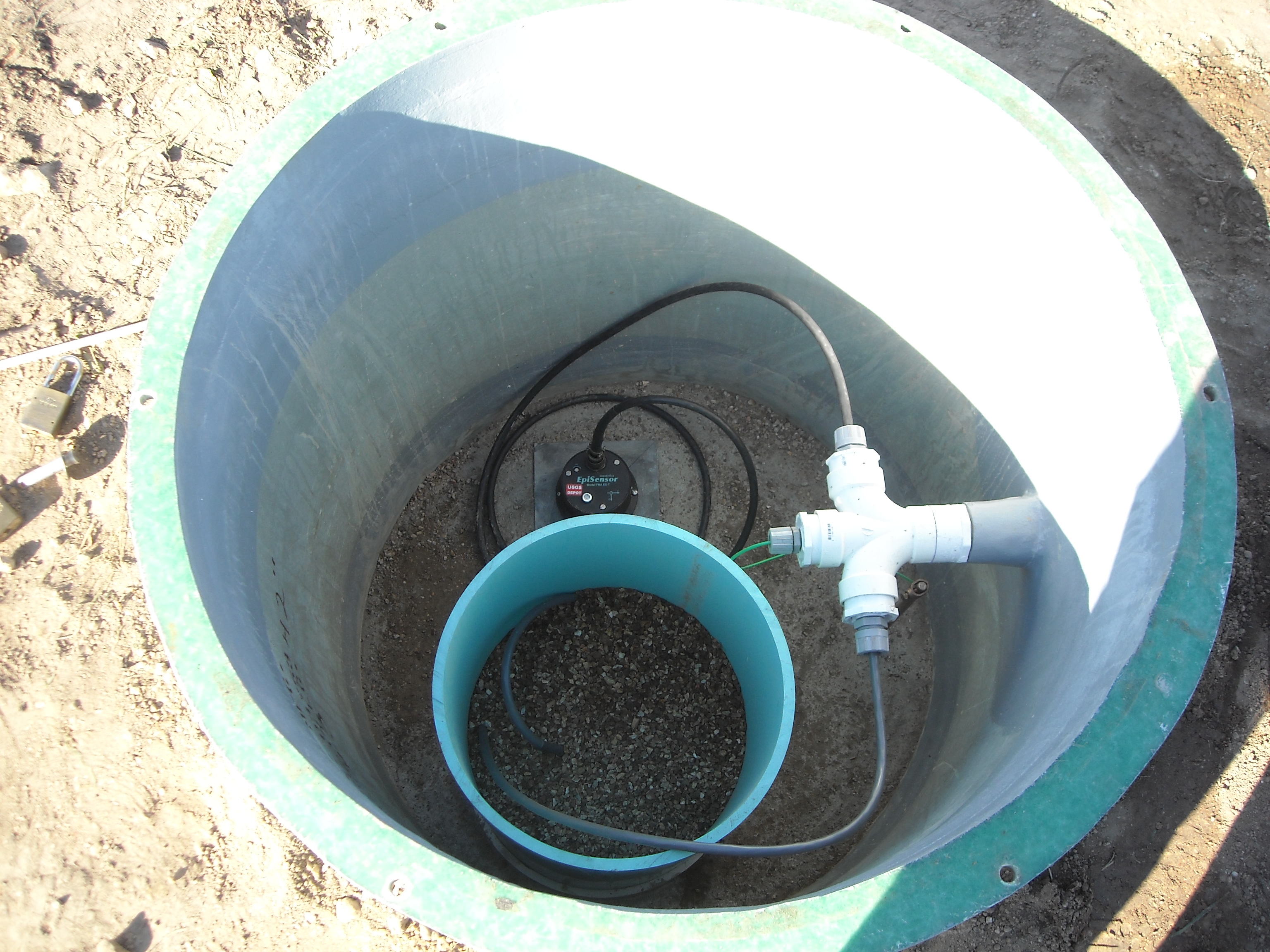

- view from inside the vaut after concrete cured

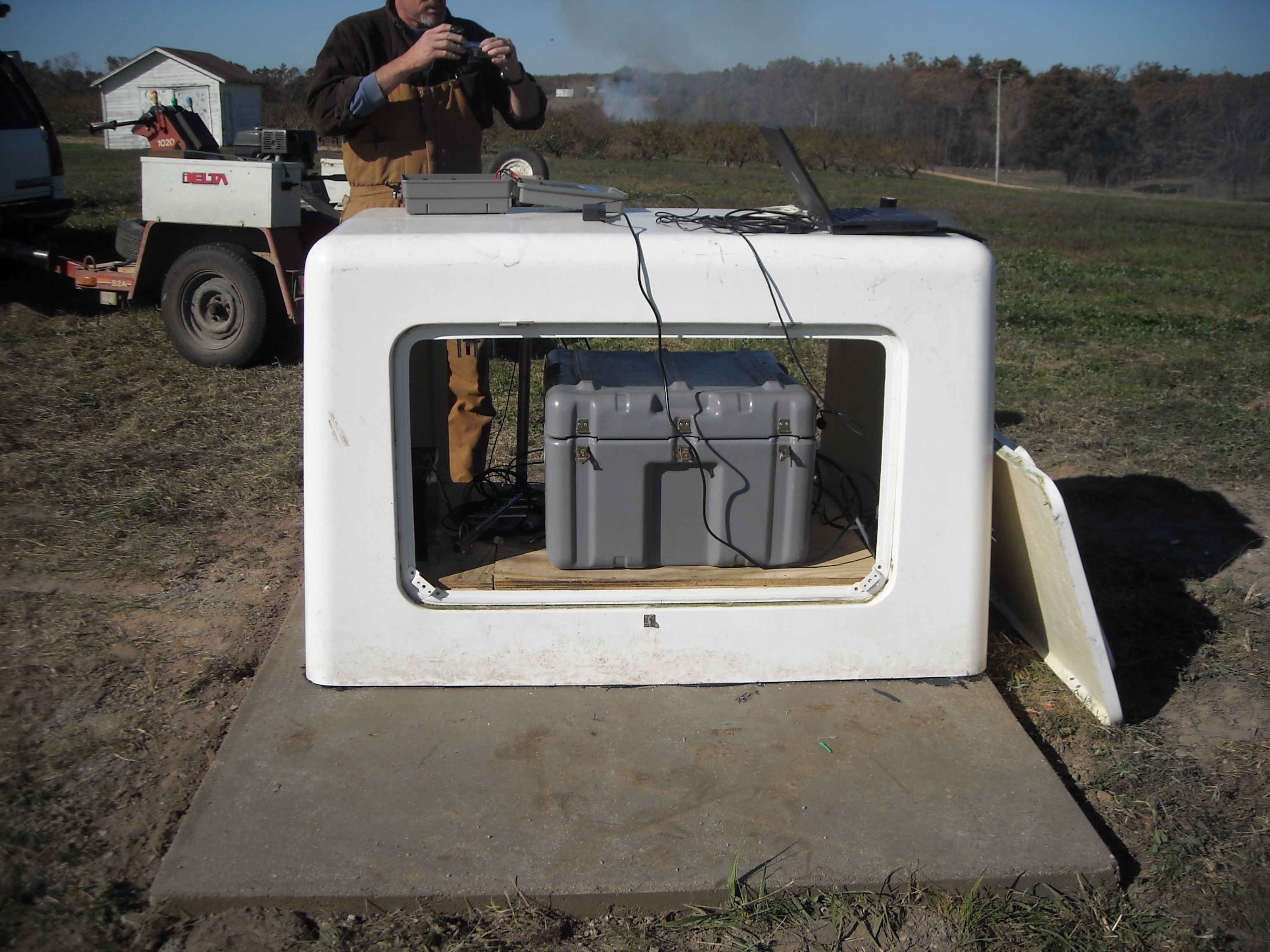

- instruments installed in vault

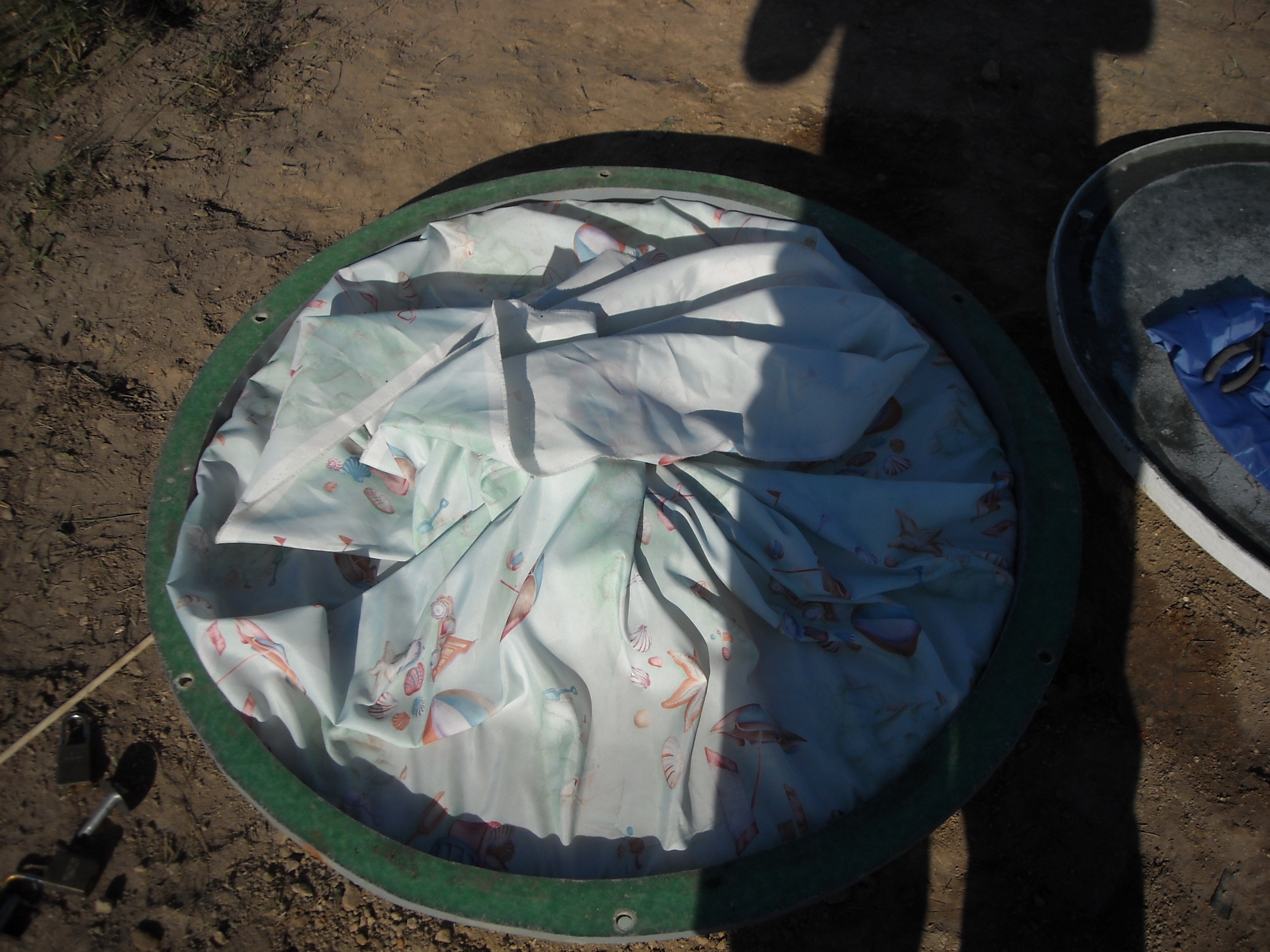

- foam plug installed in vault
- vault finished

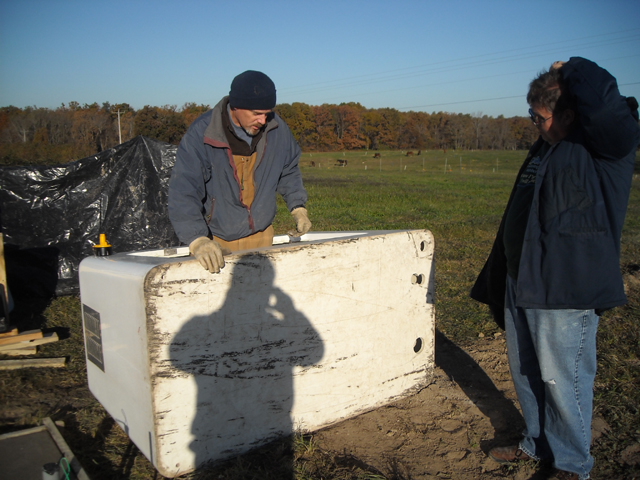

- preparing instrument shelter to be installed on pad

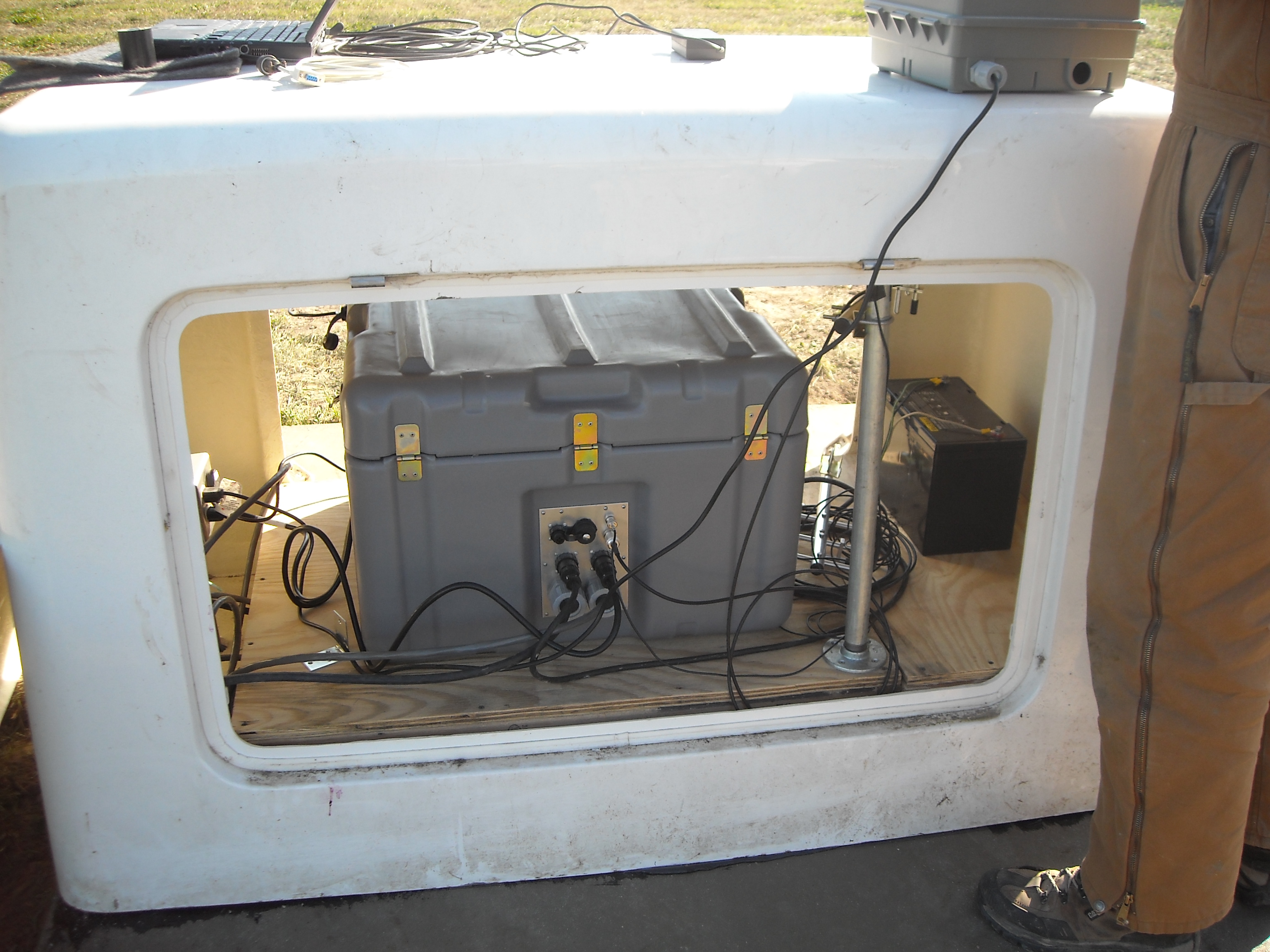

- view of equipment in instrument shelter including telemetry antenna and gps antenna

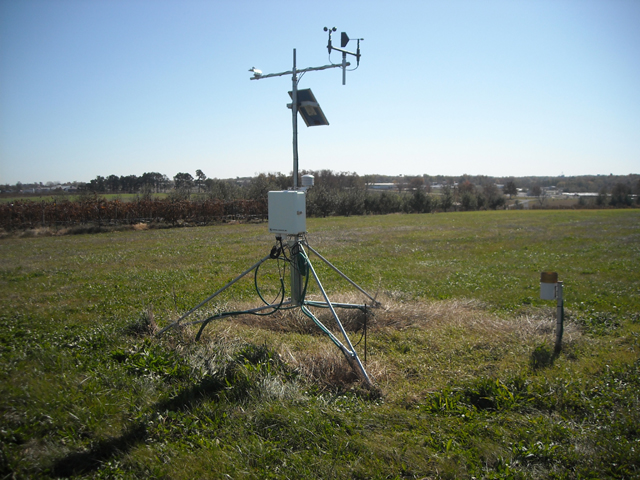

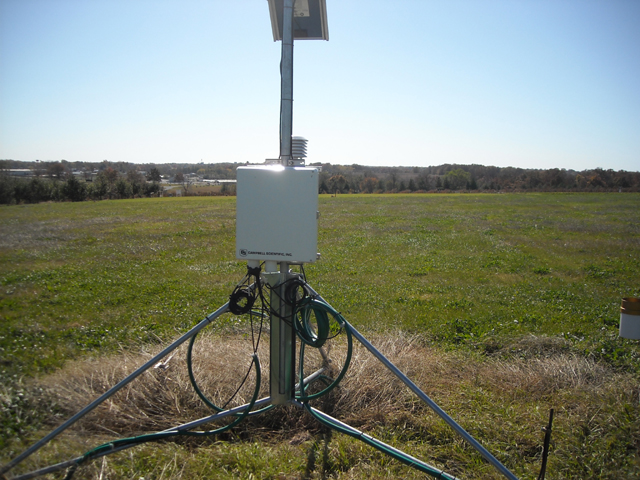

- University of Missouri weather station co-located on site
